Bob Hall Pier Completion Delayed

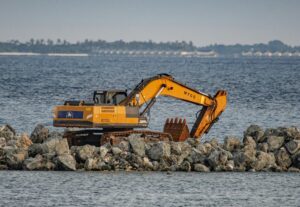

Excavator on rock jetty works along coastal shoreline with ocean in background during marine construction.

Bob Hall Pier Project Faces New Completion Timeline

Plans to reopen the iconic Bob Hall Pier in Nueces County have hit an unexpected delay, pushing the highly anticipated completion into early 2026. County leaders remain confident they will finish the project, but officials confirmed that unexpected construction setbacks have extended the original timeline.

The $28.5 million reconstruction effort, which officially broke ground on October 7, 2024, was initially scheduled for completion by January 7, 2026. However, county officials now project the pier will not be ready until mid to late February 2026.

Despite the delay, momentum on the pier build continues, and leaders emphasize that the end goal—restoring one of the Texas Coast’s most treasured landmarks—remains firmly in sight.

What Caused the Bob Hall Pier Delay?

According to Precinct 4 Commissioner Brent Chesney, the delay stems from unfinished concrete precast beams that are critical to the pier’s outer edge. Earlier this month, the primary contractor, Callan Marine, informed project leaders that it had not completed the specialized concrete components on schedule.

Concrete Beam Shortage Slows Progress

“These beams are essential structural elements,” Chesney explained, noting that the notification came as a surprise. Until recently, contractors assured county officials that the project remained on track.

“Just two weeks ago, they assured us the project would finish on time,” Chesney said. “That sudden update took everyone by surprise.” “So yes, the sudden news caught everyone off guard.” “So yes, the sudden news caught everyone off guard. Still, we’re committed to pushing forward and completing the pier.”

Fortunately, project engineers report that delivery and installation of the beams should begin in the first week of December, which could limit further disruptions if all goes according to plan.

Construction Progress Shows Visible Gains

Even with the setback, construction crews have made significant progress over the past several months. Visitors who toured the construction site in August were able to walk portions of the developing pier and view the future location of the 5,000-square-foot restaurant.

Rebuilding After Hurricane Hanna

Bob Hall Pier suffered devastating damage during Hurricane Hanna in 2020. Since then, the community has awaited not just a replacement, but a stronger, more durable structure built to withstand future storms. The current design reflects that goal by combining modern engineering with classic coastal aesthetics.

Liquidated Damages and Contract Oversight

Because a strict construction contract governs the project, Nuces County will assess liquidated damages against the contractor for missing the original deadline. Chesney confirmed this during a November public briefing.

While those financial penalties may offset some of the delay, county leaders stress that their top priority remains finishing the pier safely and correctly, rather than rushing construction.

Restaurant Construction Moves Forward Separately

In addition to the primary pier reconstruction, commissioners approved a separate $3.8 million contract in October for the third-party restaurant and concession building. The county selected LMC Corp. from a pre-approved contractor list to handle this portion of the project.

Why Callan Marine Stepped Away

Originally, Callan Marine planned to build the restaurant as well. However, the company withdrew from that part of the project in early 2025, citing scheduling conflicts. Since then, LMC Corp. has received its official notice to proceed and has already begun securing materials.

Project engineers hope construction activity on the restaurant could begin as early as December, although early 2026 now appears more likely. The restaurant will open in mid-2026, according to the current schedule.

Rising Administrative Costs for the Pier Project

As the project timeline extends, so too have administrative costs. In May, county commissioners approved an additional $75,000 to cover expanded design and construction oversight services.

This amendment also extends the county’s contract with Jacobs Engineering Group—the project’s design firm—through May 30, 2027. While the extra spending has drawn attention, officials argue it ensures proper supervision over every phase of construction.

A Pier Built for Strength and Longevity

Engineers designed the new Bob Hall Pier to closely mirror the layout and appearance of the original structure while improving its resilience. Designers plan to preserve the open-air pavilion and classic boardwalk feel that longtime visitors cherish.

Engineered to Survive Extreme Storms

At the same time, the pier’s structural backbone represents a significant upgrade. Key design features include:

  • A reinforced foundation across the deck and public areas
  • Pop-up timber deck panels
  • New protective guardrails
  • A projected 50-year lifespan
  • Wind resistance up to 150 mph
  • Structural durability capable of withstanding a 100-year storm

These upgrades aim to ensure the pier remains a safe and lasting attraction for decades to come.

What This Delay Means for the Community

The Bob Hall Pier plays a vital role in Corpus Christi’s coastal identity and tourism economy. From anglers to beachgoers and small business owners, the pier’s reopening promises to bring renewed activity to the area.

Although the delay is disappointing for many, county officials emphasize that quality and safety outweigh speed. If the remaining work stays on schedule, residents could finally see the pier reopen just weeks later than initially planned.

For now, anticipation remains high as construction teams push toward the following major milestones.
